User Guide

Capacity Report

The Capacity Report provides a structured tabular breakdown of available hours, estimated work, and logged hours - giving managers a precise view of team utilisation.

Opening the Capacity Report

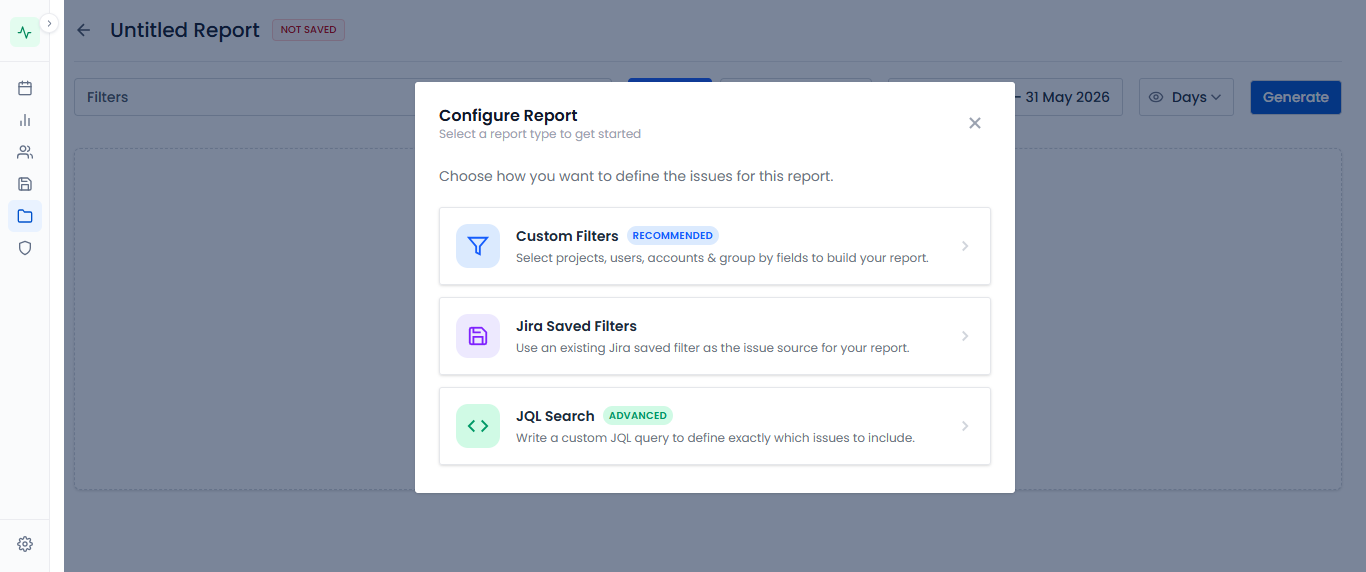

Capacity Planner & Insight → Capacity Report

Step 5

Configuring the Report

ControlOptions

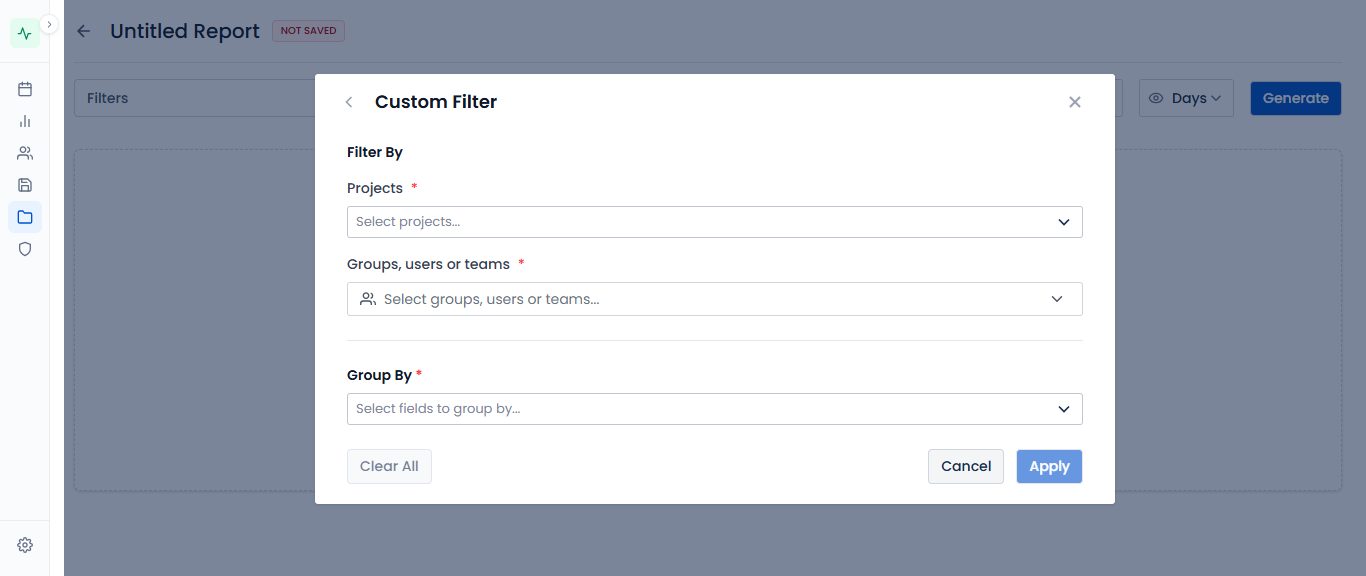

ProjectOne or more Jira projects
UsersFilter to specific individuals
TeamsFilter by teams from Teams Management
Date RangeFrom and To date picker
Issue TypeStory, Bug, Task, Sub-task, Epic
Group ByAssignee · Team · Project
View ModeDays · Weeks · Months

Click Apply after setting all controls.

Step 6

Reading the Report

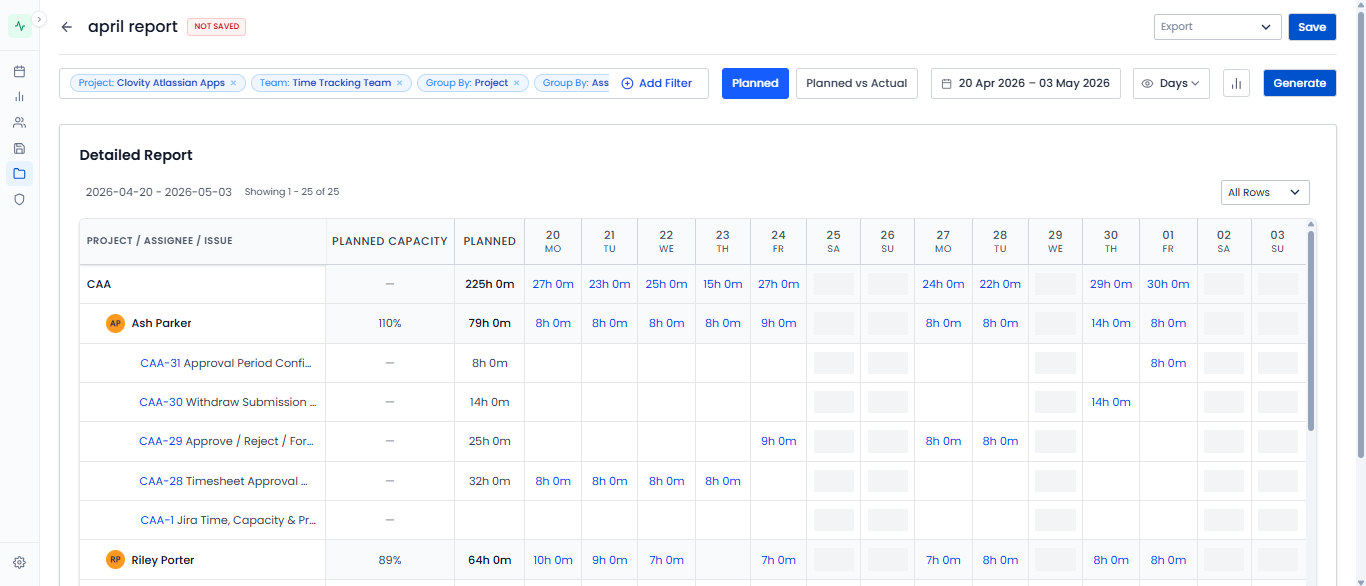

ColumnMeaning
NameUser / Team / Project (based on Group By)
AvailableTotal working hours available (working days × hours/day from Settings)
EstimatedSum of remaining estimates on assigned open issues
LoggedActual hours logged via Jira worklogs
Allocation %Estimated ÷ Available × 100 - higher means more committed

Step 7

Allocation Interpretation

Allocation %Status
< 70%Under-utilised - capacity available
70–100%Healthy utilisation
> 100%Over-allocated - risk of missed commitments

Exporting

Click Export → CSV to download the full report as a spreadsheet.

The CSV includes all rows, columns, and grouping levels for import into Excel, Google Sheets, or BI tools.

Tips

  • Run the Capacity Report at the start of sprint planning to validate commitments before finalising
  • Group by Team for a leadership-level rollup; group by Assignee for individual workload detail
  • Set Hours Per Day and Working Days correctly in Settings - inaccurate settings skew the Available column
